The Ministry of Defence has confirmed that BAE Systems will construct Royal Navy and Norwegian Navy Type 26 frigates in parallel on the Clyde, following Norway’s decision to adopt the design.

Labour peer Lord West of Spithead asked whether two build streams would be established to ensure delivery schedules for both navies are met.

Responding on 16 September, Defence Minister Lord Coaker said: “The recent announcement by the Norwegian Government to select the UK as a strategic partner for the acquisition of Type (T26) warships is expected to provide a £10 billion boost to the UK economy and support more than 400 British companies.”

He added: “Both the Royal Navy and Norwegian Navy T26 frigates will be built simultaneously by BAE Systems on the Clyde, benefitting from investments already made, such as the Janet Harvey Shipbuilding Hall in Govan. The new Shipbuilding Hall will improve schedule performance and the pace of delivery, reducing the time between future ship deliveries for both the UK and Norway.”

The Type 26, also known as the City-class frigate, is being built for the Royal Navy to replace the ageing Type 23s. Its export success with Australia and Canada had already established it as a significant international programme before Norway became the latest customer. According to the government, the dual build will take advantage of recent shipyard modernisation in Glasgow, which is designed to accelerate throughput and deliver multiple ships at pace.

BAE open huge new shipbuilding facility in Glasgow

Inside a conference room in a building overlooking the Janet Harvey Hall on Glasgow’s River Clyde, Sir Simon Lister recently laid out a clear ambition for British warship production: pace, precision, and purpose.

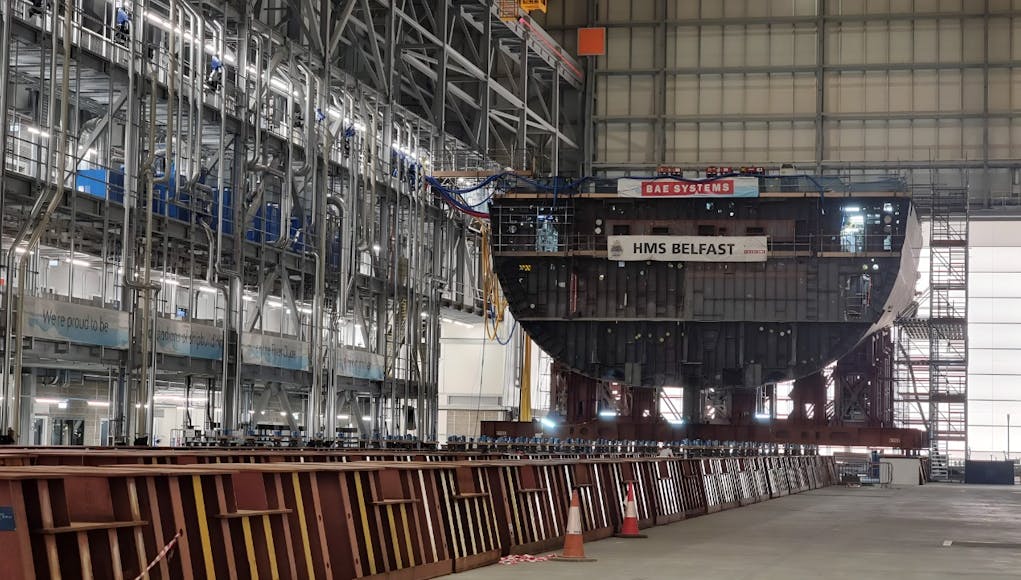

The new shipbuilding facility, one of the largest covered yards in Europe, is central to a transformation that aims to deliver Royal Navy frigates faster than ever before.

Lister, Managing Director of BAE Systems Naval Ships, described a future where warships are not just built, but engineered as “nodes in a network of military capability.”

Speaking at a media briefing, he explained, “The word I never really understood when I was the customer of this organisation was ‘integrating.’ Integrating complex things—like the programme, like the technology—that’s what BAE Systems does. We take the customer’s requirements, which are really quite sophisticated in terms of lethality and stealth, and we translate those requirements into metal, into nuts and bolts, into a computer system.”

He emphasised that while many associate warship construction with steel, the true complexity lies elsewhere. “People tend to focus on the steelwork. Actually, that’s a small part of what we do. It’s the spectacular part, but that ship really takes a supercomputer to sea.”

Cutting build time by a third

Inside the new hall, shipbuilders are working to compress the build time of the Type 26 frigates significantly. “We’re aiming to build the fourth Type 26 in 66 months,” said Lister. “From ship one to ship four we aim to improve the performance of the yard by 30 percent.”

That’s a substantial leap forward from the first-in-class, HMS Glasgow. “We’re moving from building a prototype—HMS Glasgow—and the prototype is always a giant. No surprise there. But we’re now moving into series production of a ship that we are confident we can produce one every year,” he said.

According to Lister, weatherproofing alone has transformed the productivity. “We’re taking a third out of the time to build the ship. The quality and efficiency with which we build will be so much greater because we’re building it in the dry.”

This leap in capability is made possible by a digital overhaul of the yard itself. “What we’ve done is take the shipyard digital,” said Lister. Workers now use ruggedised laptops on the shop floor instead of paper drawings. “We wanted to communicate the design of the ship digitally. It’s one thing for the designers to have this model—but now everyone on the shop floor has access to it.”

The transformation extends from fabrication to fit-out. “We’ve modernised the panel line at a cost of just shy of £20 million. It produces panels at twice the rate of the original manual line. Our operators are much safer. Welding is intrinsically dangerous—we’ve removed the person from the hazard as much as we possibly can.”

BAE Systems expects to deliver Type 26 frigates annually by the time Ship 5 enters production. “That’s the objective,” said Lister. “The ambition in all of this is to build a warship every year—and to build them well.”

For now, BAE’s focus remains on keeping pace. “The Navy wants us to build these ships as quickly as we can. That’s the cheapest way to build the ship: in the right order, at the highest pace you can safely achieve—maintaining quality all the time.”

George Allison
George Allison is the founder and editor of the UK Defence Journal. He holds a degree in Cyber Security from Glasgow Caledonian University and specialises in naval and cyber security topics. George has appeared on national radio and television to provide commentary on defence and security issues. Twitter: @geoallison

8 COMMENTS

  1. Just an observation. I’m sure HMG are just about to jump into this issue and resolve the problem.
    SDSR stated very clearly the RN will have “at least” 25 destroyers and frigates in service. We are “at least” a minimum of 6 ships short. Any chance of more type 26 being added to the programme?
    I’d have thought 2 more type 26 and a further 4 type 31s was exactly what the RN needs.
    Then add 8 -10 type 83 destroyers and job done

    • I wouldn’t hold your breath on an expansion to the escort fleet. I felt the FSL during his speech at DSCI made it pretty clear that they are putting all their eggs into unmanned systems as a cost saving measure. I would be shocked if additional orders come through other than the 3 MRSS and 6 Type 83 as major surface ships go.

      • I suspect they are putting much effort into unmanned systems although not nearly enough. Their strategy is likely to necessitate having some form of Mother ship though and I’m not confident either T26 or T31 will be much use for that. I would suggest that if serious sea trials of the T31 and/or T26 get good results then additional batches will be announced although the specific design may well be adapted.

        • Maybe they do that for Type 31 if there is a concern that exports won’t be able to keep work going at the yard, but lets not pretend that the MOD is suddenly concerned about the size of the fleet. We are talking about the same people who allowed Barrow to die off between the V boats and Astutes to save money only to cause untold damage that is still bring felt now.

    • Are you talking about the SDR25 or the previous Conservative-led SDSR? I don’t believe that SDR25 mandated a 25-ship escort fleet.

  2. What does building in parallel mean? There are two slots in the build hall so BAE are already building in parallel. Will they be assembling more than the current two ships at once and if so where? As the second part of the article is just a cut and paste of the aspirations from June, before the Norwegian order, what can we expect to see now?

    I really wish George would date his cut and paste sections. Those less used to his style can find them misleading.

    • It means that the Norway T26s will be built separately on a different site with a different workforce thus not affecting the UK build in the slightest.

  3. Yay I’ll now cheer, it’s been a long time coming but it’s now all down to BAe and the supply chain to deliver, so good luck to them. All building in parallel just means 2 in the hall side by side and then back through the assembly process, I don’t know which hull number is going to Norway but at some point it will go 1 for us and 1 for Norway.
    If they get to a 12 month drum beat by hull 5 then it isn’t going to slow the RN deliveries by much at all as the 1st 4 are at 18 month intervals.
    My main concern is the emphasis on Govan but very little is said about Scotstoun where the fitting out is carried out, I do wonder if that may be split for the Norwegian ships so some of it is carried out in Norway.

    Exciting times so now JFDI !
